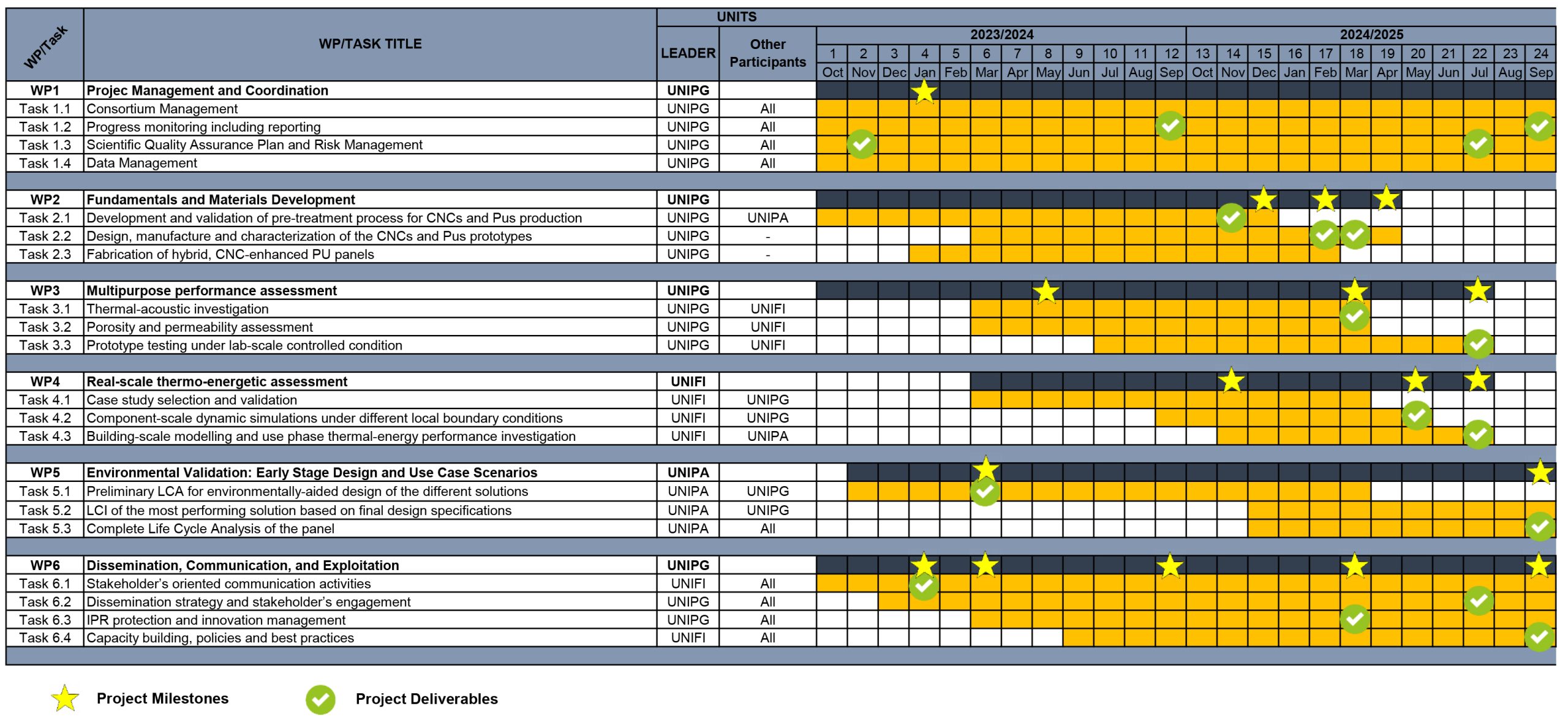

Deliverables and Milestones

WP1 – PROJECT MANAGEMENT AND COORDINATION

DELIVERABLES

D1.1 – Project guideline and quality assurance report (M2) (RESPONSIBLE: UNIPG)

D1.2 – Technical and financial periodic report (M12; M24) (RESPONSIBLE: UNIPG)

D1.3 – Project and risk management report (M22) (RESPONSIBLE: UNIPG)

MILESTONES

M1.1 – Data management plan (M4) (RESPONSIBLE: UNIPG)

WP2 – FUNDAMENTALS AND MATERIALS DEVELOPMENT

DELIVERABLES

D2.1 – Biomass pretreatment process report (M14) (RESPONSIBLE: UNIPG)

D2.2 – CNCs and PUs prototypes production report (M17) (RESPONSIBLE: UNIPG)

D2.3 – Hybrid CNC-PU panel fabrication report (M18) (RESPONSIBLE: UNIPG)

MILESTONES

M2.1 – Protocol for CNC and PU focused biomass pretreatment developed (M15) (RESPONSIBLE: UNIPG)

M2.2 – Protocol for CNC and PU production from pretreated biomass developed (M19) (RESPONSIBLE: UNIPG)

M2.3 – Protocol for hybrid CNC-PU panel fabrication developed (M17) (RESPONSIBLE: UNIPG)

WP3 – MULTIPURPOSE PERFORMANCE ASSESSMENT

DELIVERABLES

D3.1 – Performance assessment under different local boundary conditions (M18) (RESPONSIBLE: UNIPG)

D3.2 – Dynamic performance analysis and long-term investigation (M22) (RESPONSIBLE: UNIPG)

MILESTONES

M3.1 – Experimental campaign designed (M8) (RESPONSIBLE: UNIPG)

M3.2 – Experimental campaign about thermal-acoustic and porosity-permeability investigation completed (M18) (RESPONSIBLE: UNIPG)

M3.3 – Experimental campaign about dynamic investigation completed (M22) (RESPONSIBLE: UNIPG)

WP4 – REAL-SCALE THERMO-ENERGETIC ASSESSMENT

DELIVERABLES

D4.1 – Component-scale thermo-physical performance assessment (M20) (RESPONSIBLE: UNIFI)

D4.2 – Building-scale thermo-energetic performance assessment (M22) (RESPONSIBLE: UNIFI)

MILESTONES

M4.1 – Opaque envelope components and building typologies selected and characterised (M14) (RESPONSIBLE: UNIFI)

M4.2 – Component-scale modelling and thermo-physical performance completed (M20) (RESPONSIBLE: UNIFI)

M4.3 – Building-scale modelling and thermo-energetic performance (M22) (RESPONSIBLE: UNIFI)

WP5 – EARLY ECODESIGN AND ENVIRONMENTAL ASSESSMENT

DELIVERABLES

D5.1 – Early screening Life Cycle Assessment report (M6) (RESPONSIBLE: UNIPA)

D5.2 – Life Cycle Assessment and eco-design report (M24) (RESPONSIBLE: UNIPA)

MILESTONES

M5.1 – Preliminary environmental assessment of the design solutions investigated (M6) (RESPONSIBLE: UNIPA)

M5.2 – Complete Life Cycle Assessment and eco-design study of the design alternatives (M24) (RESPONSIBLE: UNIPA)

WP6 – DISSEMINATION, COMMUNICATION AND EXPLOITATION

DELIVERABLES

D6.1 – Communication and dissemination plan (M4) (RESPONSIBLE: UNIFI)

D6.2 – Final dissemination and communication plan (M22) (RESPONSIBLE: UNIPG)

D6.3 – LIGNOCAP exploitable result and IRP analysis (M18) (RESPONSIBLE: UNIPG)

D6.4 – Best Practice for multipurpose material optimization procedures (M24) (RESPONSIBLE: UNIFI)

MILESTONES

M6.1 – Project website online (M4) (RESPONSIBLE: UNIFI)

M6.2 – Templates for communication materials ready (M6) (RESPONSIBLE: UNIPG)

M6.3 – Newsletter released (M6; M12; M18; M24) (RESPONSIBLE: UNIPG)

M6.4 – Submission of at least 3 conference papers and 3 journal papers (M24) (RESPONSIBLE: ALL)
